Project SMART
Supplier Development
PROJECT PHASES
Stage I
Resolving Historical Issues On Current Supply
01
Review Supplier Records and remove obvious candidates who do not require on-going review.
01
02
Confirm current list of HIS/Key Suppliers that need to be monitored/ worked with.
Ascertain key suppliers:
- Risk, Technology, Location, History, Cost.
- Approved suppliers list.
Ask other Senior managers if new suppliers are required.
02
03
Analyse HIS main issues from SNCRs. (Root cause analysis). Set up 8D projects to resolve.
What are the key issues/root causes with HIS suppliers? Are there common denominators i.e. you have not specified clearly, not enough time, supplier process are not capable, so your ability to select suppliers etc?
03
04

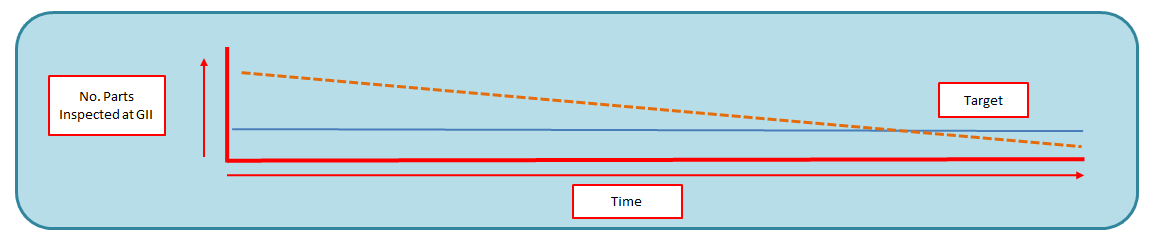

Improvement programme established (with timeline) for core HIS suppliers especially focussed on those needing GII.
04
05
Review KPIs and set up measureables and targets to improve/ delivery improvement from suppliers
05
06
Review inspection methods and samples, PPAP Control Plans
06
Stage II
Establish formal process and responsibilities
01

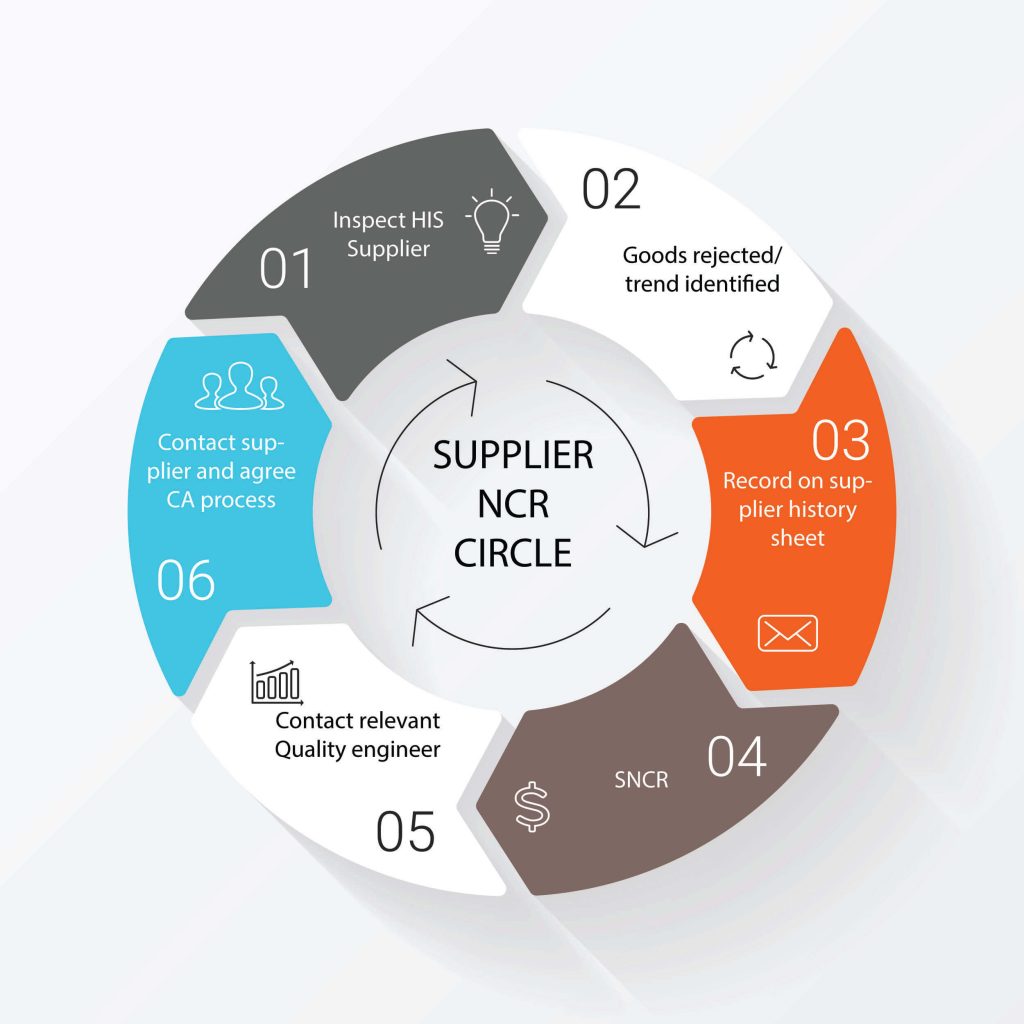

GII to monitor HIS supply performance at GII collate data (Supplier History Sheets, KPIs and SNCRs)
01
02
Review KPIs and set up measureables and targets to improve/ delivery improvement from suppliers
02
03
Review KPI Supplier Performance at Management Review
03
04
Define the approach, the policy you are to use
04
05
Initially communicate with supplier base as to what are your intentions to get them on the journey.
Letters to suppliers informing them of intention.
- Why you are doing this.
- Monitoring performance
- You will need to inform them of impending supplier requirements and quality agreements
- Supplier process control approach – your specific requirements
- On site audits
05
06
Regular performance reviews with suppliers – negatives and positives
06
Stage III - New Projects
Develop Supplier NPI Verification and Validation Process
01
Ensure Supplier NPI V&V process is embedded into APQP process.
01
02
Involvement with suppliers at front end of project
02
03
Clear requirements and specifications
03
04
Supplier input into design – what can their processes achieve?
04
05
Process controls agreed and formally described in Control Plans
05
06
Written agreements and approved samples with suppliers
06
07
On sight sample approvals and 1st off approvals
07
08
Stock check verification
08
09
Scheduled on-site audits
09
- Linking their products to performance monitoring @ GII.
(Metrology, electrical test and visual examination – against workmanship standards, drawings and specifications)
- Set up monitoring/feedback process with suppliers.
- Score cards.
- Monthly letters.
- Tie in with KPI
- Issue Supplier Agreement / Requirements, get them to agree and sign.
- Include requirement to use Process Management Flow.
- Set up scheduled supplier visits / audits.
- Define schedule i.e. Monthly / Quarterly.
- Update Approved Supplier list.
- Purchase Data Sheets updated and ready to go. (link PO to PDS).
- Drawing / Specification sheets referenced on PO must have issue number.
